Project Budget:Overview

Estimated reading: 3 minutes 224 views

Managing project budget in Zoho Projects helps teams control cost, reduce overruns and use resources well. Zoho Projects tracks planned versus actual cost in real time, supports multiple currencies, and can integrate with Zoho Invoice and Zoho Books.

Why project budgeting matters

  • Track costs accurately and keep spending on target.
  • Identify cost variances early to avoid overruns.
  • Generate invoices based on real-time project data.
  • Manage projects across countries using multiple currencies.

Budget types

  • Based on Project: set a single fixed cost and hours budget for the whole project.
  • Based on Phase: allocate budget and hours per phase; the project budget is the sum of all phases.
  • Based on Task: set budget and hours for individual tasks; the project budget is the sum of all tasks.
  • Based on User: assign cost, revenue and hours budgets per user, editable when adding a user or later.

Billing methods

  • Staff Hours: individual user rates determine project billing.
  • Project Hours: a fixed project rate multiplied by total hours logged.
  • Fixed Price for Project: a fixed amount is invoiced; needs Zoho Invoice or Zoho Books integration.
  • Task/Issue Hours: billing per hour rate set for each task or issue, useful when service rates vary.

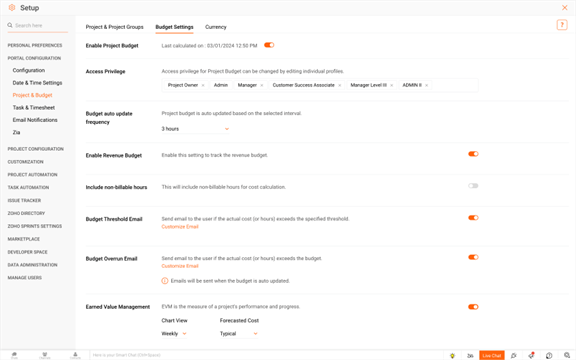

How to enable Project Budget

  1. Click the settings icon in the top-right corner.
  2. Select Project & Budget under Portal Configuration.
  3. In Budget Settings, toggle Enable Project Budget.

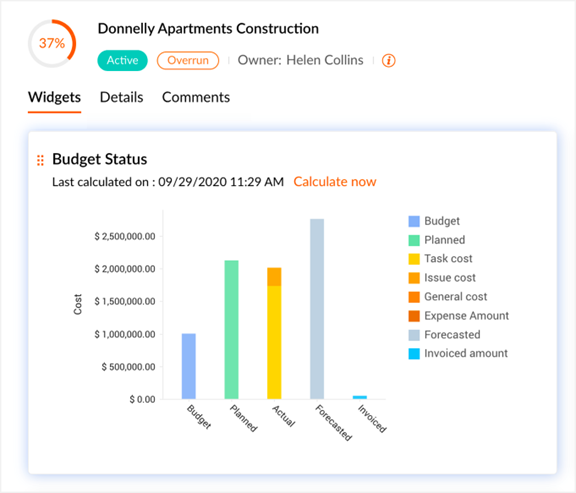

Project Budget is enabled by default for admins; other users may need permission changes. Once enabled, a Budget Status graph on the project dashboard shows planned against actual costs.

Forecasting

Forecasted cost and hours predict the likely cost of completing the project, based on current progress and actuals:

  • Forecasted Cost = (((100 minus % completion) x planned cost) / 100) + actual cost
  • Forecasted Hours = (((100 minus % completion) x planned hours) / 100) + actual hours

Viewing and tracking budgets

Budget details are visible in several places: the project list page, task and phase list views, individual task views, and the Budget Status graph on the project dashboard.

Budget status tags

  • At Risk: actual is within budget but forecasted cost or hours exceed budget.
  • Overrun: actual cost or hours already exceed budget.
  • Surplus: forecasted cost or hours remain within budget.

Managing budget overruns

  1. Go to Tasks or Phases.
  2. Filter by Overrun in the budget field.
  3. Review and adjust the affected tasks or phases as needed.

Frequently asked questions

What budget types can I choose for a project?

Project-based, phase-based, task-based or user-based, depending on where you want to track spend most closely.

What does the Overrun status tag mean?

It means the actual cost or hours have already exceeded the budget for that project, phase or task.

Need help?

Need help setting up project budgeting in Zoho Projects? Contact support@thoughtlogik.com or see our Zoho implementation services.

Leave a Reply

Your email address will not be published. Required fields are marked *

Learn how we helped 100 top brands gain success

Subscribe

×
Cancel
